Week 1 (15 Jan - 21 Jan)

  • Established a team consisting of 8 members and elected a Team Leader (Project Manager) to lead the team
  • Team name set as 6row7
  • Responsibilities and appointments were assigned. Namely: administrator, analyst, programmer and web-designer
  • Formulated project requirements and proposed the project for another team
  • Received project requirements from our client Freshmaker Ltd

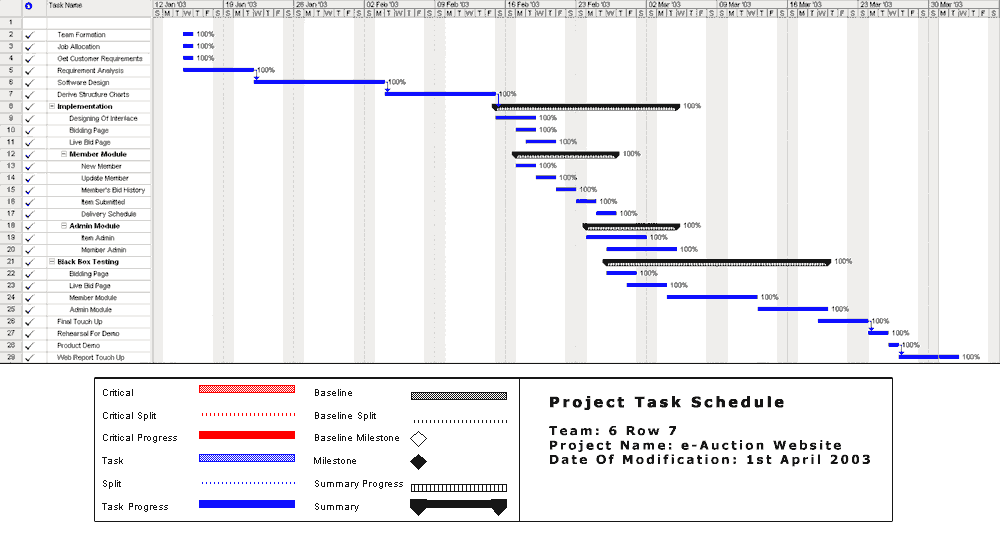

  • Developed project schedule
  • Developed preliminary use-case diagram

Week 2 (22 Jan - 28 Jan)

  • Familiarized with Rational Rose as our project modeling software
  • Decided on using ASP to implement our project
  • Refined system specifications

Week 3 (29 Jan - 4 Feb)

Week 4 (5 Feb - 11 Feb)

  • Modeled system design using Structure Charts

Week 5 (19 Feb - 25 Feb)

  • Reallocated programming workload
  • Started implementation using Visual Interdev and MS Frontpage

Week 6(5 March - 11 March)

  • Continued implementation of system

Week 7 and 8 (12 March - 25 March)

  • Completed implementation of system
  • Testing in progress
  • Compilation and generation of online report in progress

Week 9 (26 March - 1 April)

  • Completed product demo to supervisor
  • Completed online report
